Chuji Heavy Logistics Successfully Completes the Transport and Installation Task of a Batch of 110kV Transformers in Wuhan's Old City - Innovatively Collaborating to Solve the Challenge of Lifting and Positioning in a "Snail Shell"

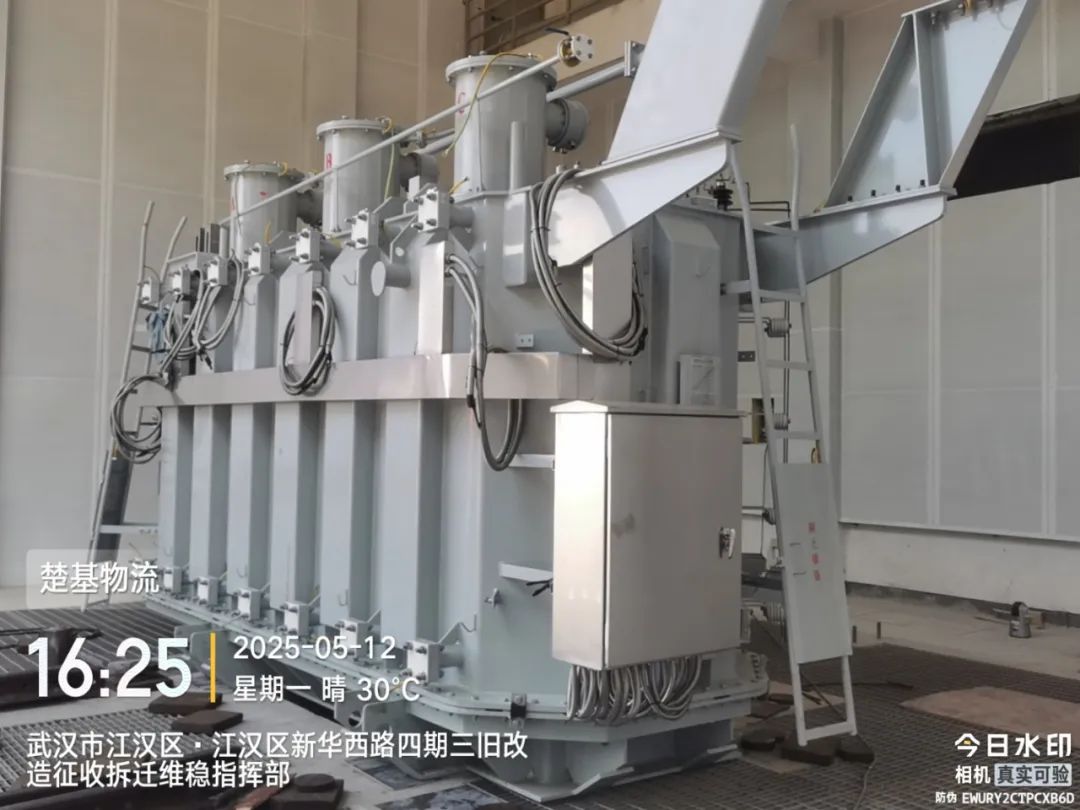

Project Background: From April to May 2025, the Wuhan Branch of Chuji Heavy Equipment Logistics was commissioned by Shanghai Electric Wujiang Transformer Factory to undertake the core task of the Wuhan City Power Grid Upgrading and Expansion Project for State Grid Wuhan Company—transporting four 110kV transformers from Wujiang, Jiangsu to the four major substation sites: Qijiashan in Dongxihu, Wuhan; Yonglichun in Qiaokou; Panlongcheng in Huangpi; and Tangjiadun in Jianghan. As a key project for the upgrading and expansion of Wuhan's urban power grid, it required overcoming the challenges of existing roads not being suitable for heavy equipment access and the limited internal space of the substations to ensure the timely delivery of the equipment. According to the established requirements, the transportation had to be efficient and precise, with the difficulty far exceeding that of a conventional large-scale substation construction project.


- Transportation positioning challenge: The of "microvasculature" transportation in the old city area
Spatial dimension limit compression: Substation entrance width less than 4.5 meters, social road width less than 4.5m, requires demolition of substation fence for vehicle entry, temporary enclosure extends to underground oil depot, demolition requires application approval cycle and incurs significant repair economic costs, and needs to re-pour substation fence.

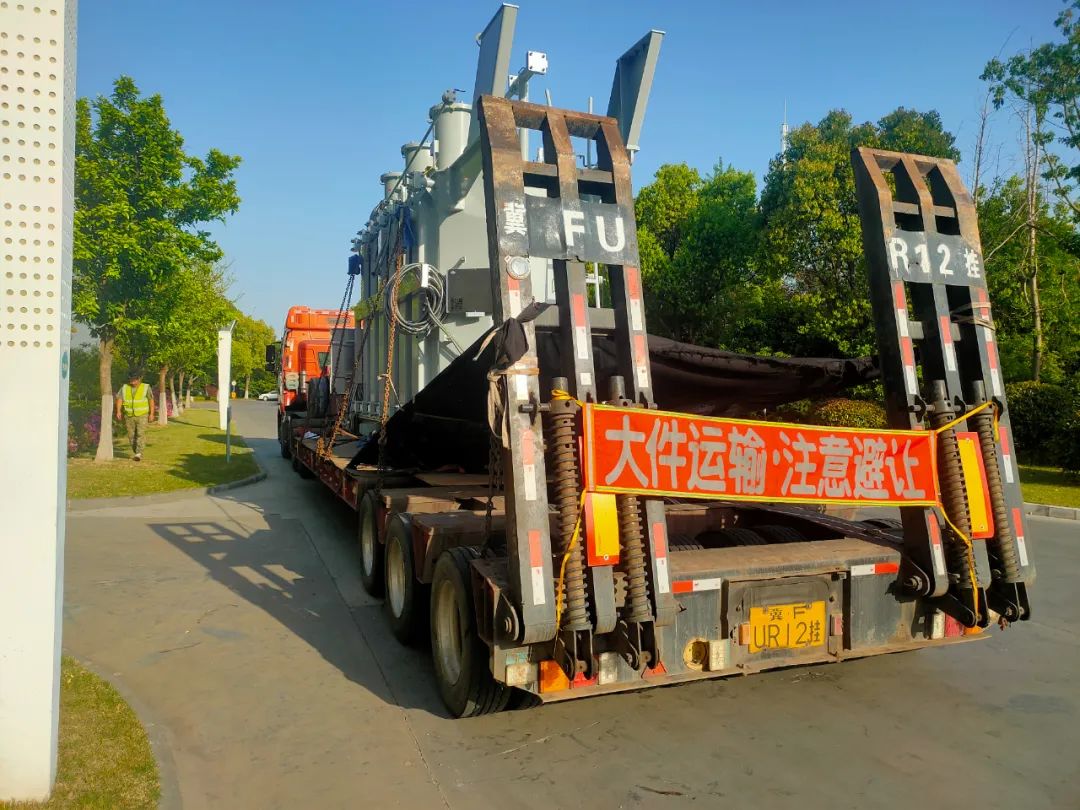

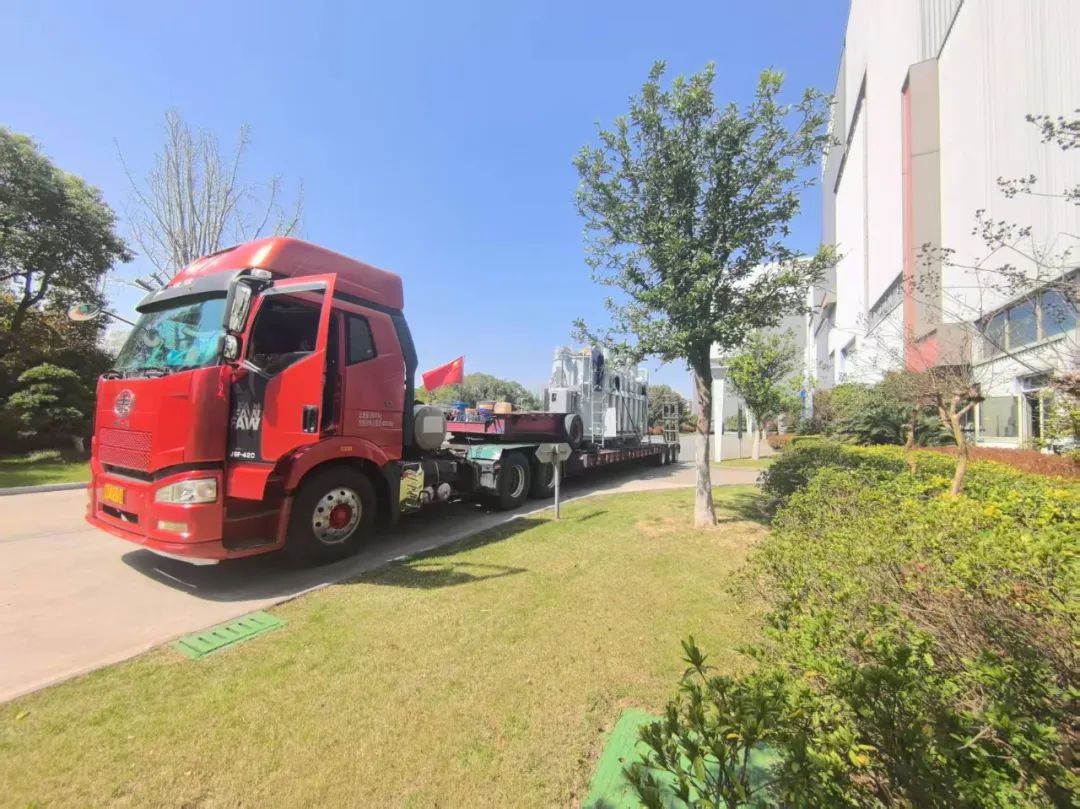

- Transformer transport vehicle needs to complete "ground-level flight" at a 90-degree sharp bend outside the site, with a total length of 23 meters front and rear for large vehicles, and a total weight of 80 tons for heavy cargo, large vehicles theoretically no longer possible.

Time window precision cutting:
Adopt a "tidal" road control: Full closure construction from 11 PM to 5 AM the next day, while completing temporary road safety measures and protective measures such as pipeline relocation and green protection.

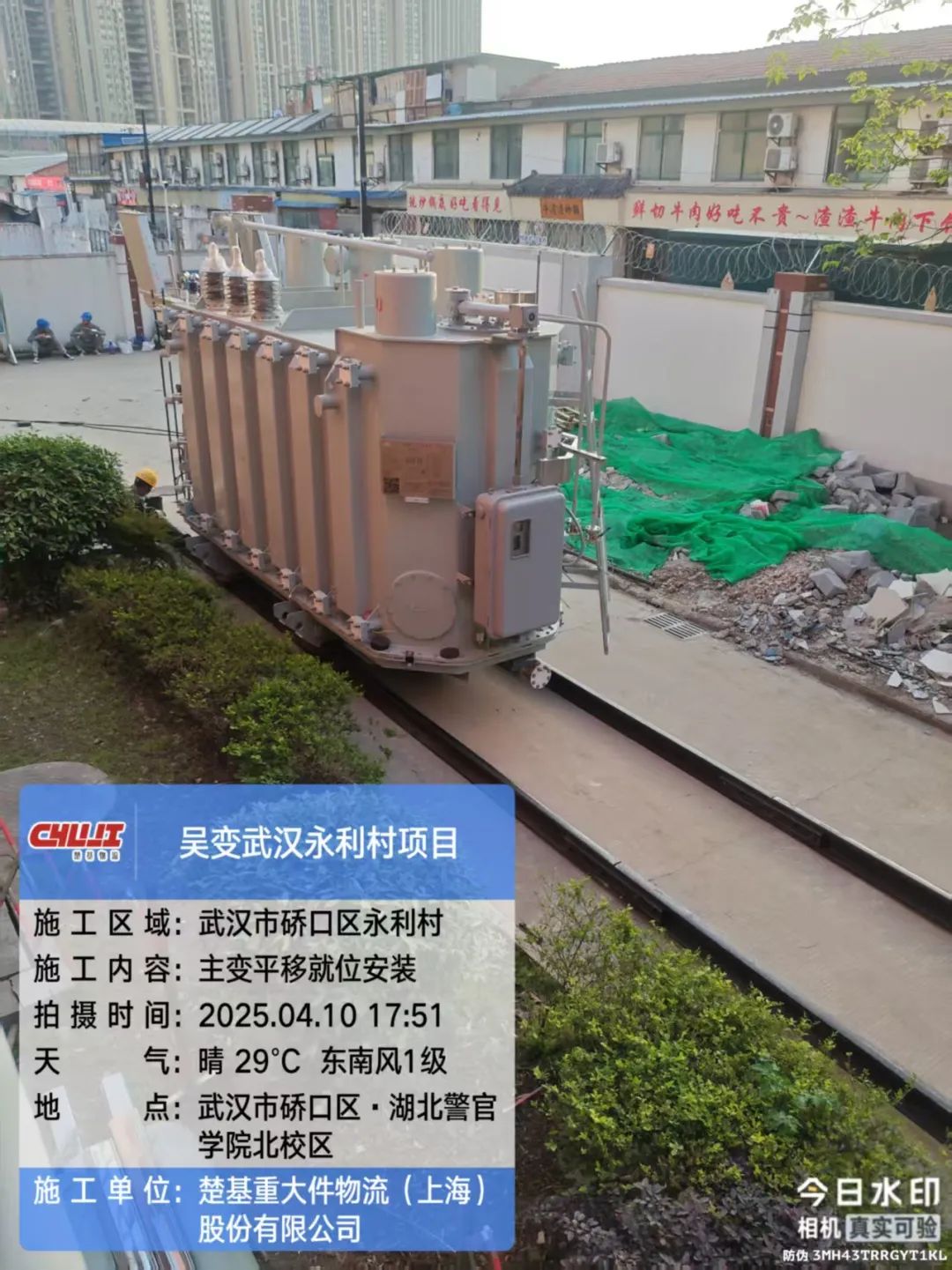

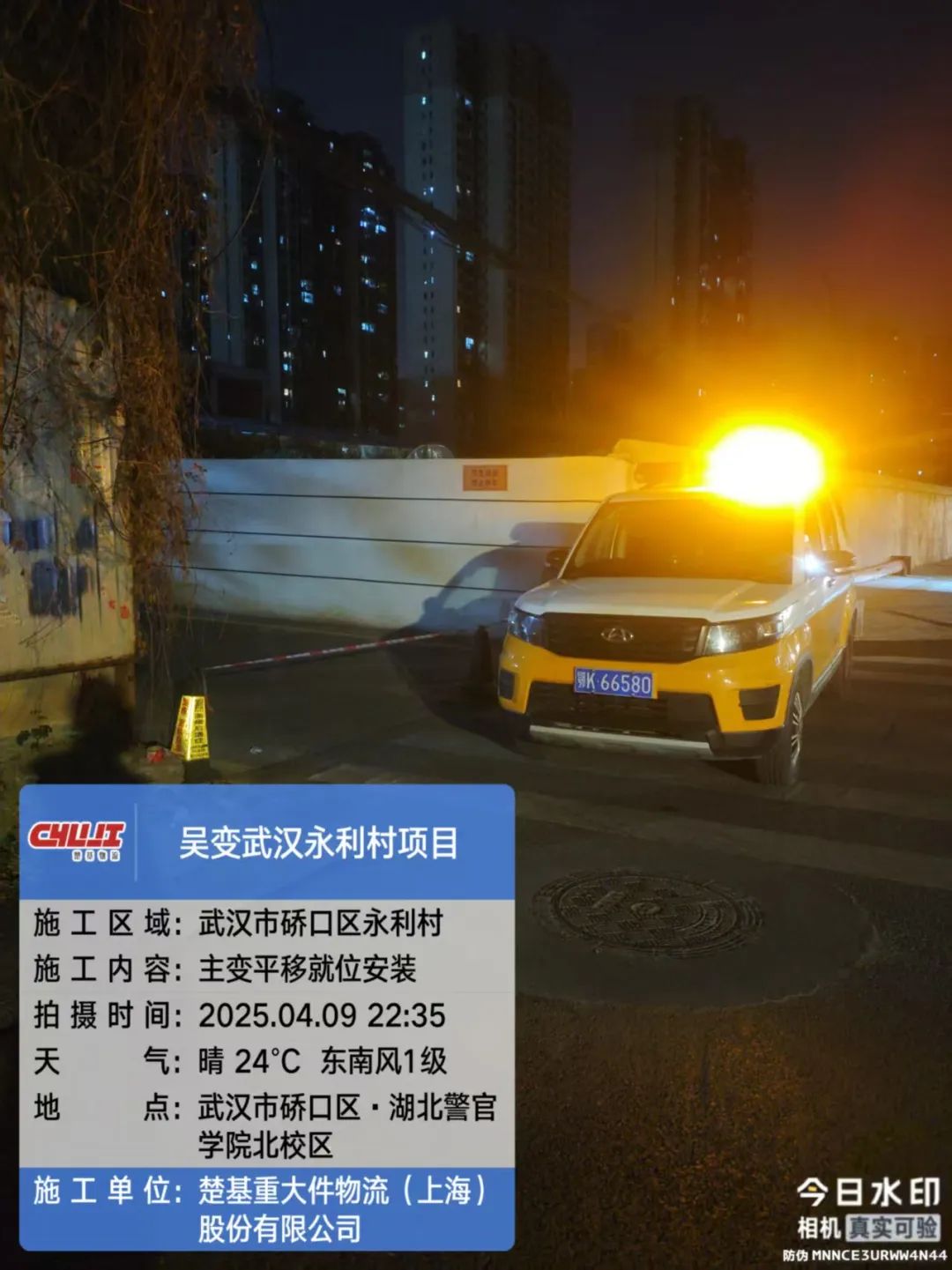

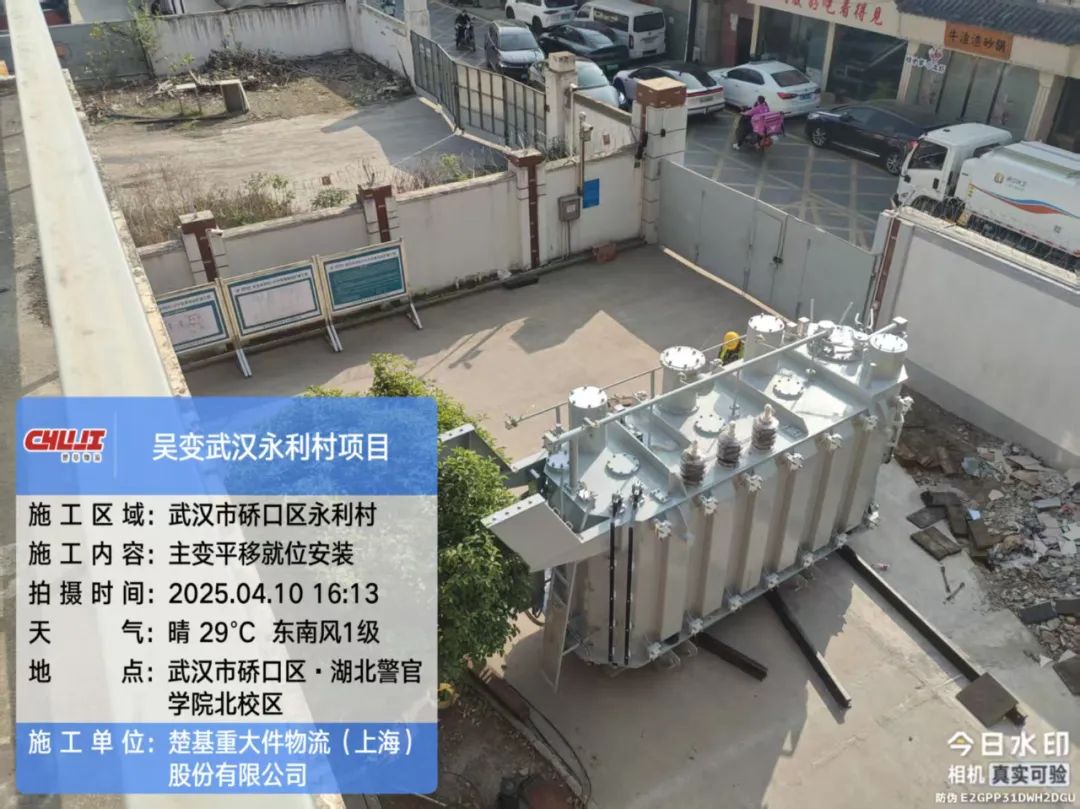

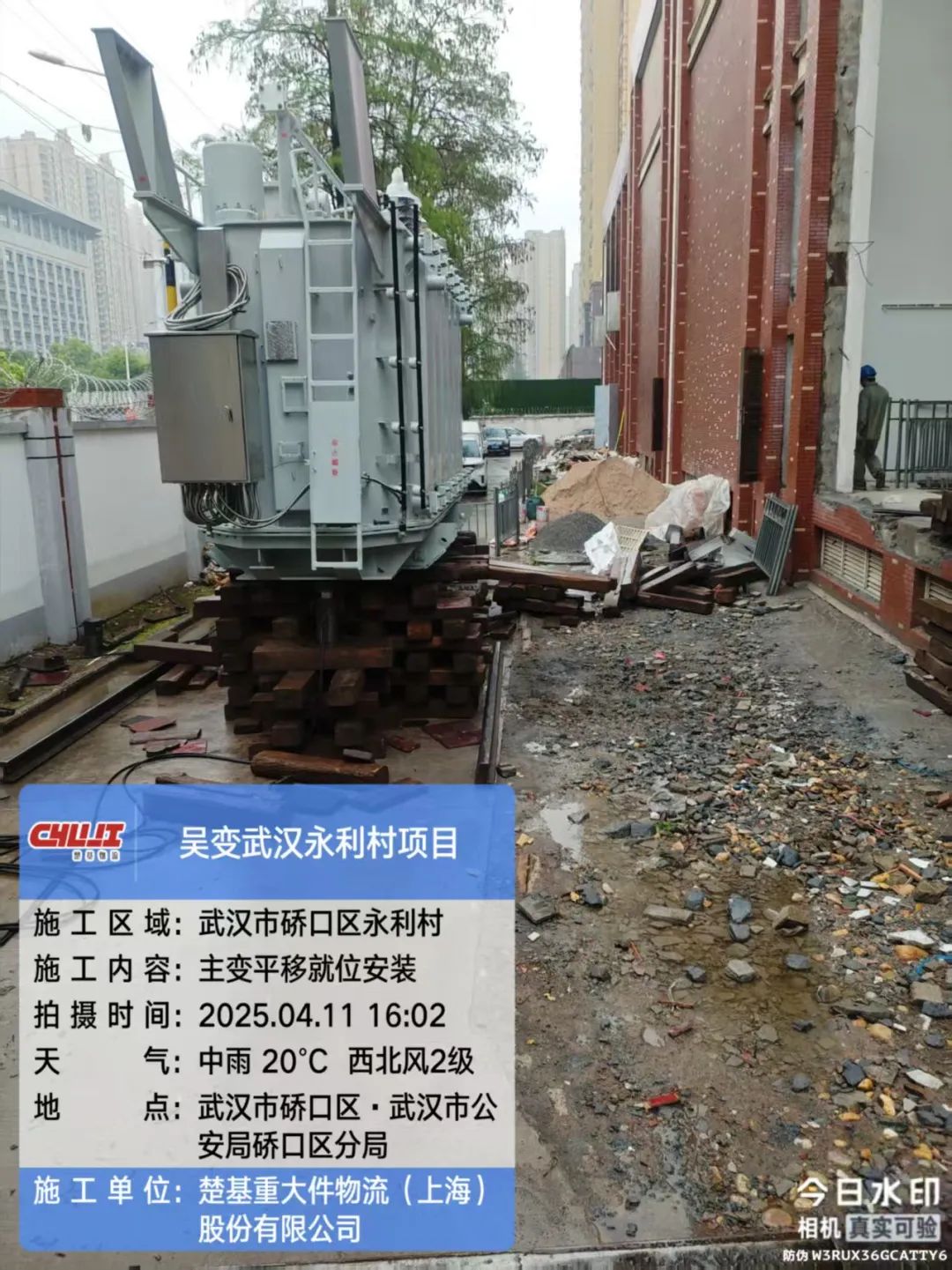

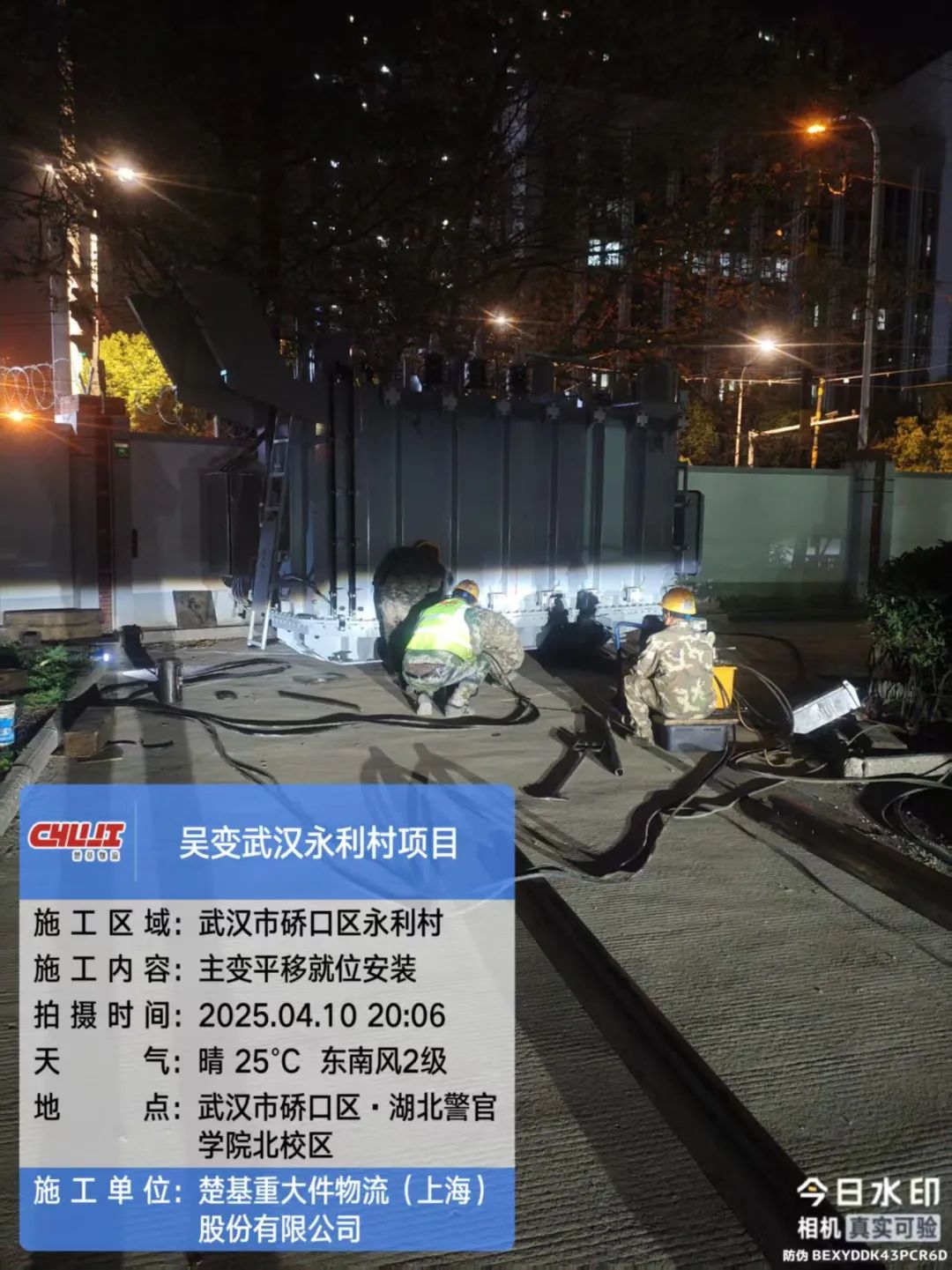

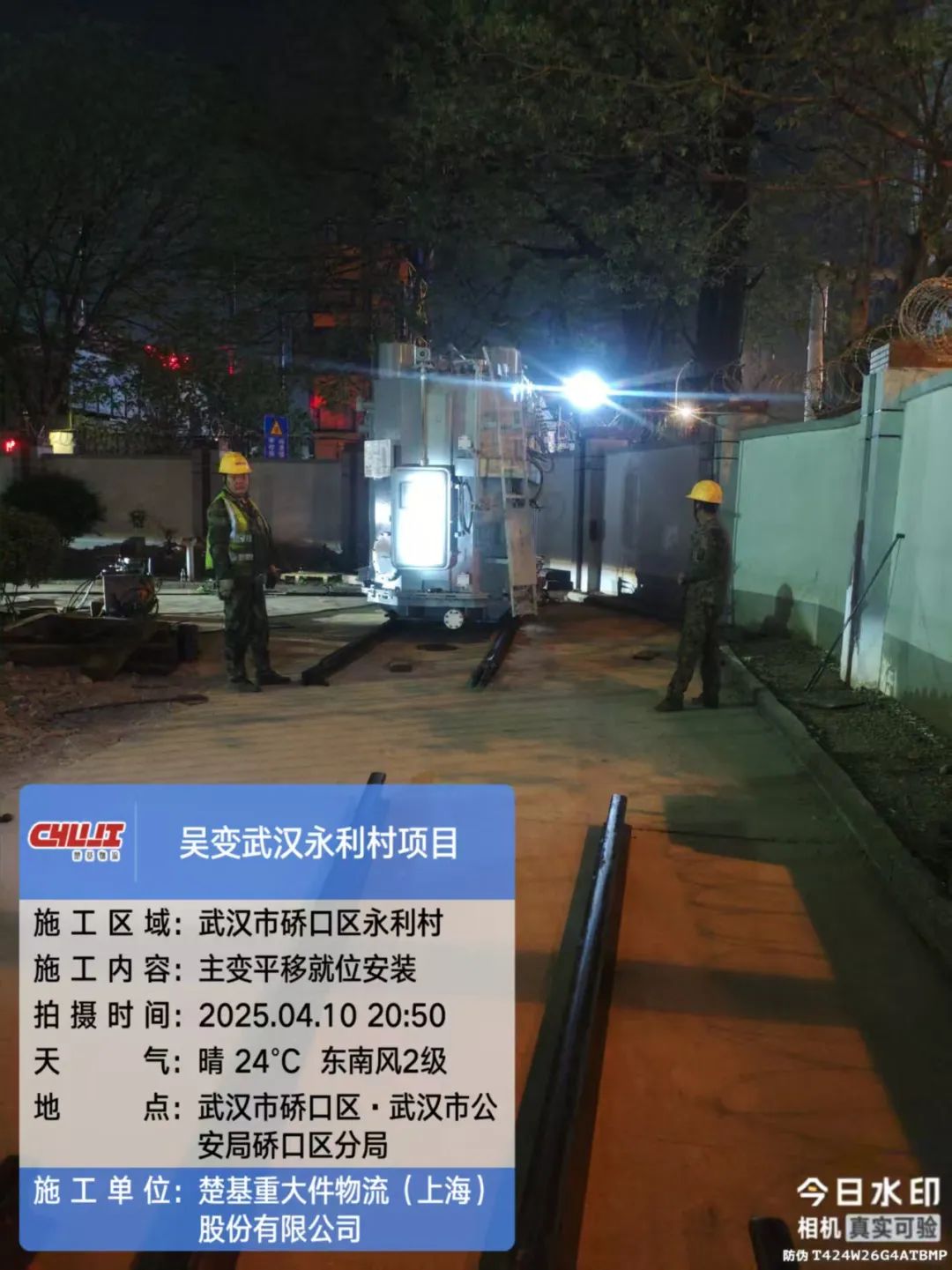

- Innovative work method: Transport hours are offset by 7 hours from peak travel times of surrounding residents, with temporary lighting and night shift teams adopting rapid work operations. Each intersection uses professional heavy-duty escort vehicles to close the road, successfully entering the substation by 5 a.m. the next day. Turning two 90-degree angles from the substation, the workload is increased by 7-8 times compared to normal vehicle operations, ensuring traffic is restored by 6 a.m. to avoid disturbing residents and not alerting local authorities.
Coordinate the network stereo structure: Establish the "1+4+N" linkage mechanism: 1 central command headquarters, 4 substation on-site teams, and N municipal collaborative units for emergency filing and communication coordination. Develop an AR real-scene simulation system to repeatedly simulate transportation route risk points in advance by 72 hours.


- Technological Breakthrough: Smart Logistics Heavy Transport Empowers Urban Renewal
Modular disassembly transportation plan

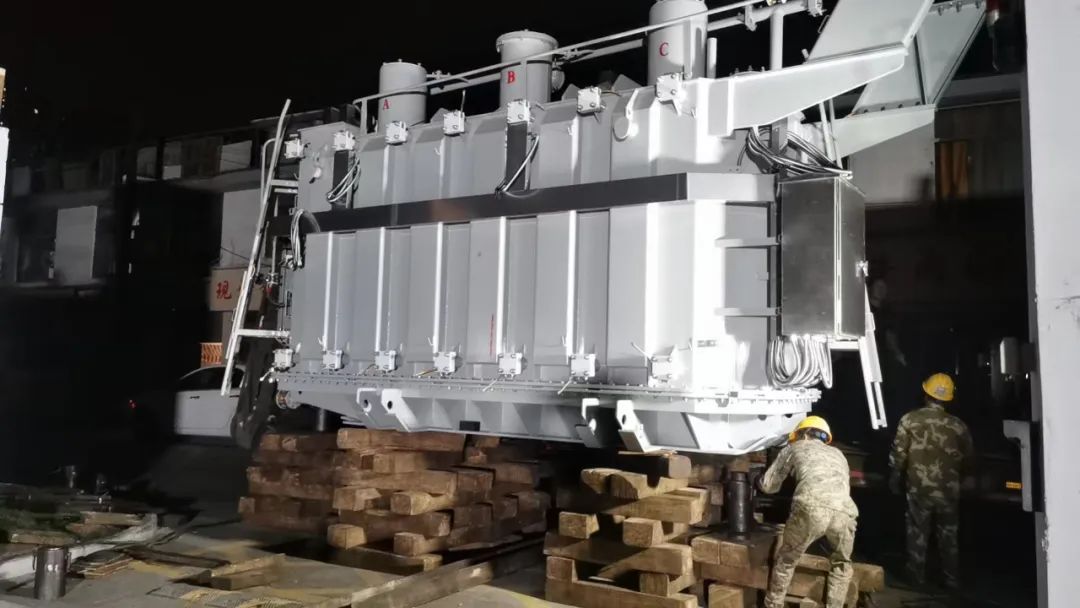

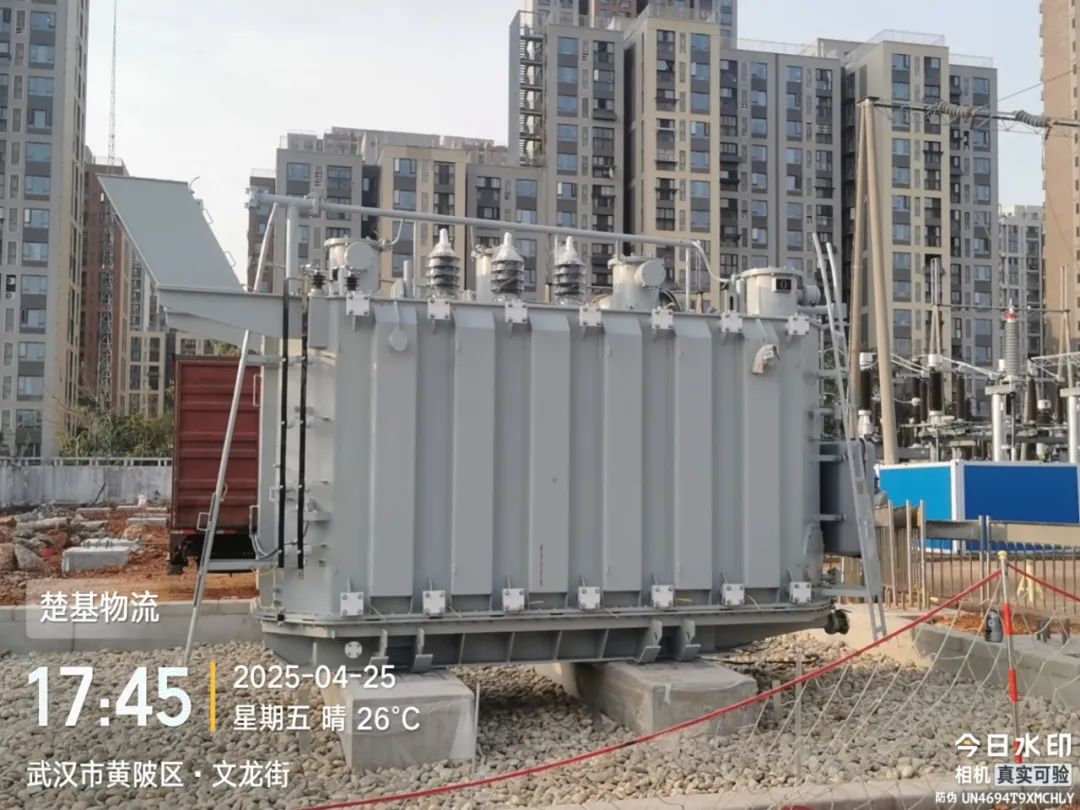

- A 25-meter-long heavy transformer transported from afar was disassembled by the team into foldable "block units," positioned vertically and horizontally using a hydraulic system, and reassembled on-site. It applied Beidou centimeter-level positioning + millimeter-wave radar to construct a "3D dynamic obstacle avoidance early warning system."
Revolutionary breakthrough in night construction in the old town
- Pioneered the "fluorescent guidance + warning light alert" composite system, ensuring a 300% increase in visibility for construction personnel while achieving no disturbance to residents.
- Road coordination diversion, the time for greening protection repair is shortened to 1/5 of the traditional process.


- Industry Value, Economic Dimension: Reedefining Transportation Standards in Complex Environments
- Saves 47% of land resources compared to building a new substation, reduces social costs by about 200,000 yuan, creates a new scenario for "night construction economy," and drives the growth of surrounding services.
- Technical Dimension and Social Dimension
Implement "zero disturbance to residents" construction, with zero resident complaints, project experience personnel, staying at Wuhan Power Construction Department for filing 7-10 days in advance, technical personnel, construction personnel training, tool and equipment qualification certificate filing, etc. Chujī major item logistics said: "This practice has verified the feasibility of 'embroidery-like' transportation. In the future, we will deepen the research on 'urban capillary logistics' and develop micro transportation exploration for scenarios such as large item transportation, micro-space construction base stations, underground pipe galleries, etc., to provide more precise logistics solutions for new urbanization construction."


Currently, the Chuji Logistics team is working on compiling the "Manual for Transportation in Ultra-Narrow Space Environments," continuously injecting innovative momentum into urban renewal by proposing the concept of "Urban Capillary Logistics," showcasing the company's strategic vision.
Recommended article
-
近日,楚基物流(上海)股份有限公司正式申领获得 LEI 全球法人识别码(编码:9845005F2AF0F65C0545),企业法人身份实现全球标准化识别,为跨境物流业务开展、海外市场合作筑牢合规根基。 LEI 法人识别码被称作企业的 “国际身份证”,是全球通用的法人实体唯一身份编码,企业信息可在 GLEIF 全球官方数据库、中国 LEI 本地系统公开核验,广泛应用于跨境贸易、国际供应链、跨国项目对接等场景,是企业开展海外业务重要的信用凭证。 作为深耕大件物流与跨境供应链领域的企业,楚基物流业务覆盖全国,重点布局中亚等海外市场,持续为海内外客户提供重大件货物运输、跨境项目物流等一体化解决方案。随着海外业务不断拓展,企业对国际化合规资质、跨境身份核验能力提出更高要求。本次顺利取得 LEI 码,标志楚基物流企业主体信息纳入全球法人识别体系,合作方可通过官方渠道查询核验企业主体信息,有效提升企业在国际项目对接中的公信力与可信度。 此次获得 LEI 编码,是楚基物流推进国际化、规范化运营的重要一步。今后,楚基物流将以...
-
2026年8月5日,烟台港集团蓬莱港营销中心副主任阮锴一行到访楚基物流,公司董事总经理李其冈、项目经理宁静出席本次座谈,双方围绕件杂货运输、重大件工程物流、新能源装备出海等重点领域开展深度合作洽谈。 座谈中,阮锴副主任对楚基物流在件杂货与重大件物流领域的专业实力和市场业绩予以充分肯定,并系统介绍了烟台港集团整体战略布局、蓬莱港在胶东半岛的件杂货业务发展现状及新能源装备出海布局,重点介绍了港口在重大件装卸作业领域的硬核优势与标杆案例。 楚基物流董事总经理李其冈深入了解烟台港业态布局与细分业务优势后表示,在新质生产力快速发展背景下,胶东半岛海洋经济基础雄厚、新能源产业增速迅猛,在全国产业转型进程中后发优势显著。随着山东区域经济持续提质扩容,越来越多外贸出海企业将烟台港作为核心战略出海口,为跨境大件物流业务提供了坚实的港口支撑与渠道保障。 楚基物流成立于2003年,为中国物流品牌价值百强企业、中交协大件物流与信息化专业委员会副会长单位。公司深耕工程物流二十余年,核心业务涵盖四大板块:重大件工程特种运输、跨境...
-
2026 年 7 月 23 日,中国水利电力物资流通协会会长潘智勇、助理胡昌贤一行莅临楚基物流走访调研。楚基物流作为协会上海代表处副主任单位,对协会领导到访表示热烈欢迎。楚基供应链党支部王书记、总经理李其冈、项目经理宁静、供应链经理黄红霞出席座谈。 会上,楚基物流总经理李其冈首先对潘会长一行的关心指导致以衷心感谢,并围绕公司本年度项目推进、车辆装备配置等重点经营工作进行详细汇报。同时汇报了协会上海代表处近期工作开展情况,表示楚基物流将顺应行业发展趋势,充分发挥桥梁纽带作用,为各地会员单位提供本地化咨询及行业信息支撑。 潘会长高度关注楚基供应链党支部建设工作,肯定企业作为民营企业在跨境综合物流服务领域取得的亮眼成效。他指出,楚基物流深耕大件、综合及项目物流二十四载,主营风电、工程机械等重大件国内及跨境运输、海外工程物流、多式联运、一站式供应链方案服务,坚持党建引领主业,积极履行行业责任,树立良好品牌标杆。潘会长详细了解企业运力装备、团队建设情况,关切询问经营发展难点,并就行业共性问题开展深入交流。 楚基供...
